Willowbrook Park

Updated: 13 January 2024

Location: Land North of A4130 Mersey Way, Didcot, Oxfordshire, OX11 7AD

Developer: Croudace Homes

Number of units: 6 flats and 4 houses


Aim(s) of Project: This Project is a Trial project to meet Future Homes Standards. Croudace is committed to building new homes that are future-proofed with low-carbon heating and world-leading levels of energy efficiency.

Construction method: Masonry with 100mm (houses) or 125mm (apartments) of insulation & a 50mm cavity

Energy Compliance method: SAP 2012

Overheating compliance method: NA


Construction start:  September 2021

Construction finish: July 2023

Overview of Project and Specification

Croudace Homes wished to trial new specifications for their houses and apartments to comply with the Future Homes Standard. This is part of their commitment to an active role in tackling the global climate crisis through the construction of energy efficient, low carbon housing.

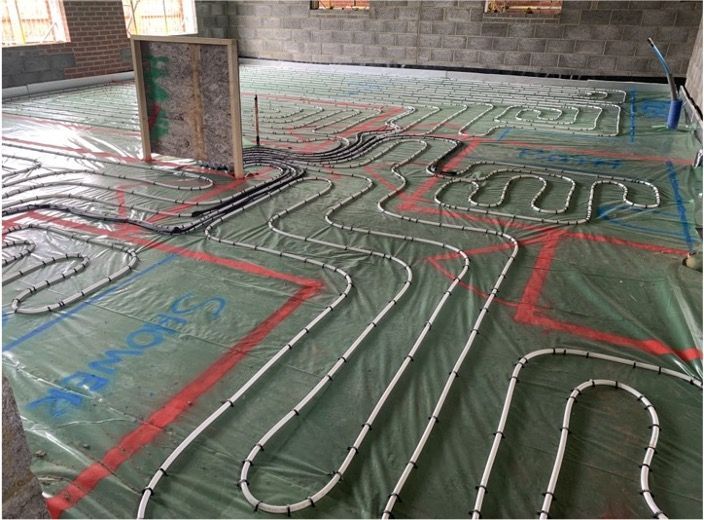

The homes are masonry construction. The houses have 350mm walls consisting of 100mm block, one layer of 100mm insulation with all joints taped, 50mm cavity and 100mm brick). The apartments have 375mm walls consisting of 100mm block, one layer of 125mm insulation with all joints taped, 50mm cavity and 100mm brick. The heating and hot water is provided by air source heat pumps. Heat is delivered via underfloor heating in the apartments and the ground floor of the houses. Upper floors of the houses use radiators. Mechanical Ventilation with Heat Recovery was used except for one house where mechanical extract ventilation was used.


More information


Visit the website


Contact Hiba Assaf


Key learnings


Cavity Wall insulation: the increased performance required two layers. The challenge was to keep them flush with one another and maintaining a clear 50mm cavity.

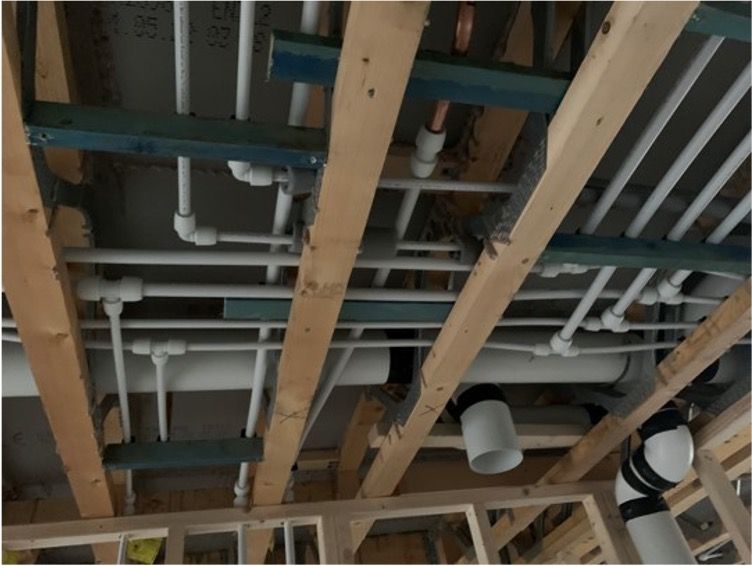

The ASHP was a split unit and the duct work:

  • Clashed with the drainage
  • Was inflexible and so required a deeper trench
  • Caused a change in the build sequence with the landscaping requiring to be finished before the heating could go on


In one house the MVHR unit could not be made to fit into the cupboard and MEV had to be used instead.

Performance evaluation


These homes will be subject to post occupancy interviews and monitoring and this case study will be updated once this has occurred.


The numbers
